A bank can have a reliable ledger and a mobile app that shows yesterday’s balance. If the app gets its data from an overnight feed, replacing the ledger could leave the delay exactly where it was. Mainframe modernization starts with that distinction. It’s the work of updating an application, its data flow or the platform it runs on so a business service can meet a specific need.
I’d build a mainframe modernization roadmap around one workload at a time. Who relies on it? What needs to improve? What would prove the change worked? For the mobile app, the first project might be a faster balance feed. Replacing the ledger deserves its own business case.
Mainframe Modernization Roadmap
A workload is a piece of work with an observable result, such as issuing a customer statement. That gives the team something concrete to measure before and after a change. This is the order I’d use.
- Describe the service. The application owner records who needs the result, when it’s due and what happens if it’s wrong. For statements, the deadline and the closing balance both matter. The output is a baseline the business owner recognizes.
- Trace the dependencies. The team lists the scheduled jobs, shared files, databases and downstream consumers. A printed report with no daily readers might still feed a quarterly audit. The output is a dependency map from discovery with an owner for each unresolved item.
- Choose a path. The owner compares keeping the workload in place with changing or replacing it. Each option gets a cost estimate, an operational risk and a reason to reject it. The output is a short decision record.
- Pilot a bounded change. A good first candidate has a representative input, a result you can compare and a way back. A statement generator can produce files in isolation while the original system continues delivering statements. The output is a comparison using the same input on both systems.
- Rehearse the switch. Operations checks the processing deadline, compares business results and practices recovery after an interrupted run. The business owner signs off on the discrepancies the team can explain. An unexplained balance difference keeps the pilot open.
- Transfer ownership. The receiving team needs the alerts, restart procedure and authority to respond. Retirement of the old job follows confirmation of downstream consumers, retrieval of retained records and the end of the agreed recovery window.
AWS’s mainframe assessment guide also calls for estimating migration labor and post-production costs during discovery. That estimate is useful before the pilot consumes engineering time.

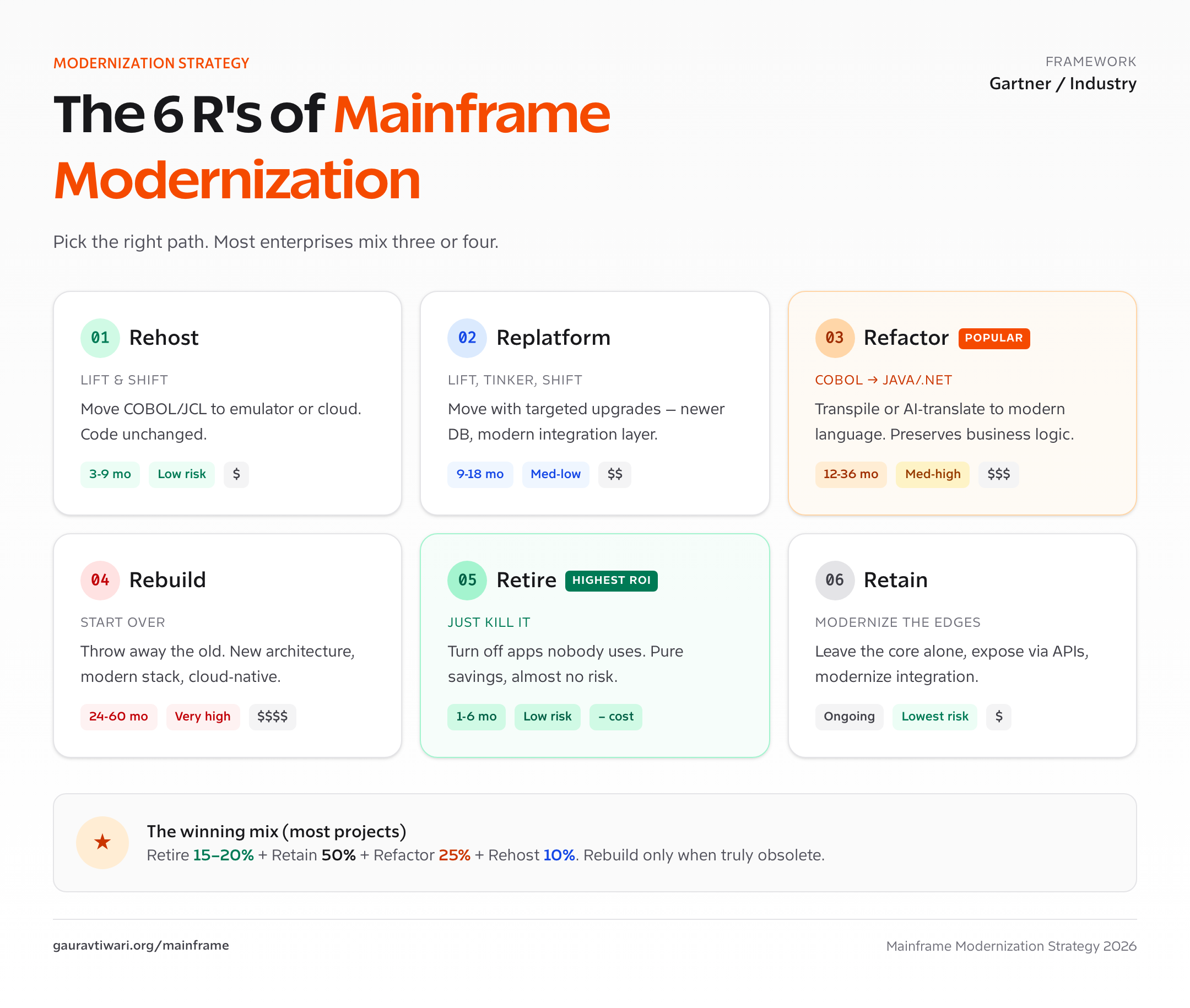

Mainframe Migration and Replacement Options
One business service can justify several choices. A bank might keep its ledger on the mainframe, retire a duplicate report and change the way its mobile app reads balances. These are practical options for a workload review. The broader choice between cloud-native development and legacy modernization depends on how much of the existing service still meets its purpose. AWS groups some of these choices differently. Its cloud migration framework includes buying a replacement and relocating infrastructure.
| Option | When it fits | Evidence I’d want |
|---|---|---|
| Retain and integrate | The core meets its targets, but another application needs faster or simpler access. | A working interface with a freshness target, access controls and a named owner. |
| Retire | The output has no remaining business or regulatory use. | Confirmation from dependent teams, including seasonal users, plus a tested way to retrieve required records. |
| Rehost | The application can run largely as it stands on a compatible target. | A representative job completes with the required outputs, response time and licensed dependencies. |
| Replatform | A supported runtime, database or other platform component needs to change while the application largely keeps its behavior. | Evidence that data ordering, numeric precision and restart behavior survive the change. |
| Refactor | A specific part of the application is hard to change or prevents a needed release. | Tests that describe the existing business rule and a small change that can ship independently. |
| Rebuild | The business rules have changed enough to justify a new implementation. | An owner for the new rules, accepted examples and a staged transition from the old service. |
| Replace with a package | A maintained commercial product already supports the business process. | A fit check against exceptions, data export rights and a plan for cases the package can’t handle. |
M&T Bank had a practical reason to retain its core. The application that helped the bank approve or decline payments was reading deposit information that could be 3 hours old. In a pilot described by IBM and the bank, events from its z/OS applications kept that information current for the consuming application. The bank could test how quickly the payment application received new information while its core continued to process deposits.
Mainframe Modernization Costs
I would start a cost estimate with the invoice items that can actually disappear. A report can move to the cloud while the bank still pays for its existing mainframe capacity, support team and software license. A cost allocation on a spreadsheet becomes a saving only when the organization can stop paying it.
IBM’s sub-capacity reporting can use the highest rolling four-hour average for an eligible product in the reporting month. Other agreements use consumption commitments. Moving an overnight batch job may leave the daytime billing peak untouched. The contract and workload measurements determine the size of the saving.
Suppose a team is comparing two ways to run the same statement service. Both estimates include staffing, licenses, storage, support and recovery at the agreed service level. These are illustrative US dollar amounts for one workload.
| Cost component | Illustrative amount |
|---|---|
| Current annual cost | $240,000 |
| Annual cost after cutover, including costs retained on the mainframe | $180,000 |
| One-time discovery, conversion, overlapping operations and testing | $150,000 |
| Annual saving after cutover | $60,000 |
| Simple break-even after cutover | 2.5 years |
The simple calculation divides $150,000 by $60,000. Now suppose $40,000 of annual license cost that the team expected to eliminate will continue. The annual saving falls to $20,000, and break-even moves to 7.5 years after cutover. The workload processed the same number of statements in both estimates. One contract assumption changed the decision. These figures exclude discounting and growth. For an AWS target, the cost of security and recovery controls belongs in the estimate. Volume, staffing and a longer overlap can also change the result.
Testing and Cutover
A successful cutover means the customer receives the right result on time and the operations team can recover from an interruption. I’d agree on those conditions with the business owner before setting a launch date.
COBOL Conversion Checks
A converted interest routine can compile and still credit the wrong amount. If the original program keeps extra decimal places and rounds only when it posts the balance, rounding each daily accrual in the new version can change a statement total. The team needs examples for small balances, reversals and period boundaries, including the original rounding rule. I would also check how it handles signed packed-decimal fields and the character encoding used by each input file.
An AI assistant can suggest an explanation or a code change. The acceptance test is a comparison against known business results, with a deadline for the batch and a restart from the last completed checkpoint. IBM’s Bob Premium Package for Z offers application analysis and refactoring capabilities. The analyst who owns the interest rule still needs to reconcile the results.
Parallel Runs and Rollback
For a statement pilot, both jobs can read the same protected input and write to separate output locations. Only the approved delivery process sends statements. I’d compare account IDs, record counts, balances and exceptions. Timestamps or layout differences may be acceptable under an agreed rule. An unexplained difference in the amount due should stop the switch. Google Cloud’s Dual Run documentation illustrates this same-input, two-output validation pattern.

Rollback becomes harder once a new service accepts writes. Sending traffic back to the old ledger could lose a payment that only the new ledger recorded. Before cutover, the team needs a tested way to preserve and reconcile those writes, a clear stopping condition and someone with authority to act. For a statement file, recovery may instead mean restarting from a checkpoint and proving that no customer receives a duplicate.
TSB’s 2018 migration shows why the customer-facing test matters. The UK Financial Conduct Authority says the data moved successfully, yet customers lost access to banking services when the new platform failed. In 2022 the FCA and Prudential Regulation Authority fined TSB a combined £48.65 million. TSB’s 2018 annual report separately records £330.2 million in post-migration charges. The operational test I’d take from that case is whether a customer can complete a payment and whether staff can recover the service if it fails.
Choosing a Mainframe Modernization Partner
My first request would be a walkthrough of one completed workload that resembles yours. A useful reference can explain what was running before, who operated the new system and what happened when something went wrong. When evaluating a software development agency, I’d put these questions in the request for proposals.
- Who on the proposed team can trace a COBOL field from a shared copybook through the batch job to its downstream consumer?
- Can the team demonstrate a restart on a representative workload and show how it detects missing or duplicate records?
- Which estimates depend on a license ending, a supplier’s runtime or access to a subject-matter expert? Who bears the cost if the assumption changes?
- Who owns the resulting source, test fixtures and build scripts? Can our team build and operate the application after handover?
- Which named business and operations owners can accept a variance, pause the cutover or authorize recovery?
A supplier’s service page, such as EffectiveSoft’s mainframe modernization offering, can help you identify a prospective bidder. A customer reference should cover the team and tooling that bidder proposes for your workload.
Service availability is part of this check. AWS says its Mainframe Modernization managed-runtime and self-managed experiences are closed to new customers. It directs new evaluations toward vendor-direct offerings and AWS Transform where appropriate. A proposal naming an AWS capability should identify the exact runtime, contracting route and support owner available to your organization.
Mainframe Modernization FAQs
Does mainframe modernization require a cloud migration?
No. An organization can keep the core application on its mainframe and change how another service reads its data. M&T Bank piloted that approach for a payment decisioning application that needed fresher deposit information.
What should a mainframe modernization roadmap deliver first?
The first deliverable is a record of one business service, its owner, its dependencies and its current performance. For a statement job, that includes the delivery deadline, the source of balances and the people who can explain exceptions.
When is replacing a mainframe application worth considering?
Replacement is worth considering when the business process has changed or a supported package already handles the required rules. An evaluation should include rare exceptions, historical data access and the transition cost. A package that fails a required year-end adjustment can still need substantial custom work.
How long should a parallel run last?
Long enough to cover the workload’s material business cycles and failure cases. A month-end or year-end event can be replayed from protected, representative inputs. Acceptance depends on reconciled results, approved exceptions and a successful recovery rehearsal.
What happens to the old data when an application is retired?
The data owner identifies the retention requirements, the people who need access and the method for retrieving records. A useful retirement test is asking an authorized employee to retrieve a historical record after the application has been switched off in a rehearsal.
How much downtime should a mainframe migration allow?
The business owner sets the maximum tolerable interruption for the service. Operations then tests whether its recovery design can meet that time and how much recent data it could lose. Those are the recovery time objective and recovery point objective, respectively. A component SLA describes the supplier’s commitment under its stated conditions.
Choosing the First Workload
I’d start with a workload the business understands well enough to challenge the result. A monthly statement is a good candidate if the team can reproduce its inputs, explain its balances and keep delivery under one system’s control. If nobody knows who consumes the output, tracing that dependency is the first project.
The decision after the pilot should fit in a paragraph. What improved? Which costs can the organization actually remove? Who can recover the service? Those answers give the person funding the next workload something firmer than a platform preference.
